Construction Costs in Los Angeles

What drives the number, why it varies so widely, and how to get from a planning range to a real budget on complex residential projects.

Every owner planning a construction project in Los Angeles asks the same question: what does it cost per square foot to build? Here are the current planning-level ranges for custom residential construction in the Greater Westside, Pacific Palisades, Malibu, Beverly Hills, and Bel Air, based on current market pricing as of early 2026.

Quick Reference: 2026 Cost Ranges

$750-$1,000/SF
Custom Home
Flat Lot
$1,000-$1,400+/SF
Custom Home
Hillside
$1,400-$1,800+/SF
Steep Hillside
High-End Finishes
$1,800-$2,500+/SF
Top-Tier Custom
Full Amenity Package

These ranges reflect custom residential construction with architect-designed specifications. Commodity construction with standard off-the-shelf products typically falls below $750/SF.

Project Type Range (Per SF) Key Assumptions
Renovation / Remodel
Flat lot
$400-$750+ Existing structure, custom-level finishes. Structural mods and full MEP replacement push higher; primarily cosmetic work lands lower.
Ground-Up New Construction
Flat lot, custom finishes
$750-$1,000 Standard geotech, conventional foundations, wood-frame or light-steel, custom materials and systems. Below $750/SF typically reflects commodity-level products and standard construction methods rather than custom residential work.
Ground-Up New Construction
Hillside, custom finishes
$1,000-$1,400+ Complex foundations (caissons, grade beams), significant site development, access logistics, extended schedule.
Ground-Up New Construction
Steep hillside, high-end finishes
$1,400-$1,800+ Steep/challenging sites, complex structural systems, significant shoring and retaining, high-end interiors. Site development 25-30%+ of total.
Top-Tier Custom
Full amenity package
$1,800-$2,500+ Extensive site development, architecturally unique structures, high-end interiors, full automation, pools, spas, sport courts, guest houses, motor courts, comprehensive landscape architecture.

These are planning-level ranges, not budgets. Every project is different. The variables that determine where a specific project falls within its range include site conditions, foundation requirements, structural systems, finish selections, and construction duration. Each of these is covered in detail in the sections that follow.

Most owners arrive at this page with a number already in their head, from a real estate agent, a friend who built recently, or a contractor who quoted a project over the phone. The number is almost always a single cost-per-square-foot figure with no context behind it. What they discover here is that the number they were given could mean almost anything, because it depends on what area was measured, what scope was included, what site conditions were assumed, and what level of supervision and management was behind it. A $1,000/SF quote on a flat lot with wood framing and a $1,000/SF quote on a hillside with caissons and structural steel are not the same project, the same risk, or the same quality of construction. Understanding the structure behind the number is what this page is for.

Numbers below $750/SF typically reflect commodity-level construction with standard off-the-shelf products rather than the custom residential work this page addresses. If your project involves a hillside site, significant subterranean construction, or complex permitting, your costs will tend toward the higher end of the applicable range. If you are building on a flat lot with standard geotechnical conditions and conventional wood framing, you will tend toward the lower end.

This page explains the structure behind these numbers: the components of a construction budget, the forces that push the cost, and the process of getting from a planning range to a real number. It is the most detailed publicly available breakdown of residential construction costs in the Los Angeles market. Last updated March 2026.

About This Page
This page covers the structure and components of a residential construction budget in Los Angeles, explains the forces that drive cost, and provides planning-level cost ranges for different project types and site conditions as of early 2026. Written by Jeff Benson, Principal of Benson Construction Group, based on current market pricing and project experience across the Greater Westside, Pacific Palisades, Malibu, Beverly Hills, and Bel Air.

The Most Common Question (and Why It Is the Wrong One)

Cost per square foot, used in isolation, tells you very little about what your specific project will cost. Two 5,000-square-foot houses built on the same street in the same year can differ by millions of dollars depending on site conditions, foundation requirements, structural systems, mechanical complexity, and finish selections. A flat-lot house in Mar Vista with standard soils and wood-frame construction is a very different project than a hillside house in the Hollywood Hills with caissons drilled into bedrock, a structural steel frame, and retaining walls holding back the slope. Quoting both at "X dollars per square foot" obscures the factors that actually drive the cost.

A second problem is less obvious but equally important: when someone gives you a cost-per-square-foot number, you rarely know what is included. One contractor tells you $1,000 per square foot. Another tells you $1,200. The natural assumption is that the first contractor is less expensive. But the $1,000 number might assume more owner-supplied materials, may not include permitting or utility coordination, and may carry different assumptions about what the owner is providing versus what the contractor is responsible for.

The $1,200 number might include all of that plus finish trim and appliances. Beyond inclusions, the two numbers may also reflect very different levels of supervision and project management on site, and different expectations for the caliber of skilled tradespeople performing the work. Reducing supervision and management overhead is one of the first places a contractor can lower a number, and it is not where you want the savings to come from on a complex project. Without a detailed breakdown of inclusions, exclusions, and the management structure behind the price, you are not comparing two prices. You are comparing two different scopes of work, and the headline number is not a complete picture of which one actually covers your project.

A third issue matters for how your project is delivered. On a lump-sum contract, the contractor's profit is the difference between the contract price and the actual cost of the work. That structure can create incentives to find savings after the contract is signed, which may or may not align with the owner's expectations for quality and specification adherence. A cost-per-square-foot number tells you what someone is willing to commit to before the project starts. It does not tell you how that number will be managed during execution, which is where delivery method and contract structure become important.

This is why a blended cost-per-square-foot number, the kind that comes up at a dinner party or in a real estate listing, is not particularly useful for budgeting a specific project. It is a single number applied across the entire building area, and it obscures the fact that different parts of the project cost very different amounts to build. A fully excavated, shored, waterproofed basement costs far more per square foot than above-grade living space on the same project. A garage costs less. A cantilevered deck built on structural steel over a hillside costs something different again. When those areas are blended into a single rate, the number does not tell you what anything actually costs to build. What a budget needs is a component-level breakdown where each area of the building is priced according to what that space requires to construct, not a blended average that treats every square foot the same.

Three Problems with Cost Per Square Foot
It hides scope differences. Two numbers at different price points may cover different scopes of work. The difference may be in what is included and excluded, but it may also reflect different levels of project supervision and site management, and different expectations for the skill level of the tradespeople performing the work. A lower number is not always a better number. Without a detailed breakdown of inclusions, exclusions, and the management infrastructure behind the price, the comparison is not accurate.

It reflects contract structure, not just cost. On a lump-sum basis, the contractor's margin is the difference between the contract price and the actual cost of the work. That structure means the owner and contractor have different financial incentives once the contract is signed, which is one of the reasons delivery method selection matters.

It ignores what drives the cost. Site conditions, foundation depth and complexity, structural systems, and finish level create a range so wide that a single number per square foot cannot capture it honestly.

Same Budget, Five Different Numbers

There is a fourth problem that most owners never see until they are deep into a project: the same budget produces completely different cost-per-square-foot figures depending on which area measurement you divide by. On a recent hillside project we managed, the same construction budget produced five legitimate $/SF numbers ranging from roughly $950 to $2,500, each using a different denominator that a different party might reference.

Denominator Approx. SF Approx. $/SF Who Uses This Number
Residential Floor Area (interior livable per zoning) ~1,400 ~$2,500 Zoning calculations, real estate listings
Building Code Area ~3,100 ~$1,130 Code compliance, LADBS plan check
Enclosed Building (to outside face of exterior walls) ~3,100 ~$1,050 Construction scope, no outdoor structures
Total Construction Scope (with deck and outdoor structures) ~3,600 ~$950 Everything the contractor builds

This is the same project, the same budget, and the same builder. The only thing that changed is the denominator. When comparing cost estimates from different sources, the critical questions are: what area are they dividing by, and what costs are they including in the numerator? A builder who measures to the outside face of exterior walls and includes decks and outdoor structures in the total area will quote a lower $/SF than a builder who measures to interior livable space only. Neither number is wrong. They are measuring different things. Without both definitions, a per-square-foot comparison is meaningless.

Watch for This: Some builders include total roof drip-line area or covered outdoor space in their square footage calculations, which produces a larger denominator and a lower per-square-foot figure. Always ask how the area is measured and what is included in the cost. A number that looks lower may simply be using a larger denominator.

Why Different Spaces Cost Different Amounts

A blended cost-per-square-foot rate treats every square foot of the project as if it costs the same to build. It does not. A finished basement bedroom that requires excavation, shoring, reinforced concrete walls, waterproofing, and full interior finishes is a fundamentally different scope of work than a garage with a slab, framing, and a door. On the projects we manage, we price each area of the building according to what that specific space requires to construct.

Building Component Typical $/SF Range What Drives the Rate
Below-grade living space (bedrooms, bath, finishes) $1,200-$1,400 Most expensive SF in the project. Excavation, shoring, concrete walls, waterproofing, drainage, full interior finishes
Above-grade living (steel or wood frame, full finishes) $750-$1,100 Structural system, full interior finish package, MEP. Steel frame pushes higher; wood frame lands lower
Garage $425-$575 Slab, framing, garage doors, EV rough-in. No premium finishes
Cantilevered deck (structural, no conditioned space) $300-$400 Significant structure (steel beams, columns, waterproofing, glass guardrails) but no enclosed, conditioned space
Trellis or open covered structure $75-$100 Posts, beams, hardware, footings. No membrane, no enclosure, no conditioned space

When these areas are blended into a single rate, the number does not tell you what anything actually costs to build. A $950/SF blended rate on a hillside project with a basement, deck, and garage contains components ranging from under $100/SF to over $1,400/SF. Understanding the component structure is how a construction manager evaluates whether a budget is realistic, and it is the foundation of the cost analysis we provide during pre-construction.

Commodity Construction vs. Custom Construction

Before discussing budget structure and cost ranges, there is a fundamental distinction that explains much of the cost variation owners encounter: the difference between commodity construction and custom construction. Understanding this distinction is essential for interpreting cost-per-square-foot numbers, because the two approaches produce very different buildings at very different price points, and comparing them directly creates confusion.

Commodity construction uses pre-fabricated, off-the-shelf products that are manufactured at scale and available for immediate purchase. Interior doors come from a catalog and can be picked up the same day. Vanities are ordered from a manufacturer's standard line. Hardwood flooring is a mass-produced engineered product at $3 to $8 per square foot. Hardware is selected from what is in stock. Cabinetry is semi-custom at best, meaning standard box sizes with a selection of finishes and door styles. These products are designed for efficiency: they arrive ready to install, lead times are short, and labor costs are lower because the work is straightforward.

Custom construction is a fundamentally different process. Interior doors are designed by the architect or interior designer, with shop drawings that can take four weeks to develop, eight weeks to fabricate, and additional weeks to install with the precision the design requires. Cabinetry is built to the specific dimensions of each space, with custom profiles, materials, and hardware that are selected individually and often sourced from specialty manufacturers with extended lead times. Flooring might be a site-finished solid oak in a custom width and stain that is not mass-produced, installed at $20 to $30 per square foot before the finish is applied. Door hardware can be a custom or artisan product that costs $500 to $2,000 per set rather than $50 from a home center.

The cost difference between these two approaches is not incremental. It is structural. Custom fabrication requires shop drawings, approval cycles, longer fabrication timelines, and skilled installation that takes more time and more coordination on site. When this level of customization applies across every trade on the project, including millwork, tile, stone, hardware, fixtures, glazing systems, and specialty finishes, the cumulative cost impact is measured in hundreds of thousands of dollars on a typical custom home.

Why This Matters for Cost Ranges
When you see a cost-per-square-foot number at the lower end of any range, particularly below $750/SF on a ground-up project, that number almost certainly reflects commodity-level products and standard construction methods. That is not a criticism of those projects. It is a different type of building. The cost ranges on this page reflect custom residential construction, where the design intent, material selections, and level of craftsmanship are specific to the project. Understanding which category a quoted number falls into is one of the most important questions to ask when comparing construction costs.

The Challenge of Committing to a Number

Before getting into the budget structure, it is worth understanding why producing an accurate construction cost is a process that requires real work. It is a function of how construction pricing actually works and how information develops over the course of a project.

A valid construction budget is built from competitive subcontractor bids and confirmed material pricing. Not all budgets meet that standard. Some are based on historical cost data, some are rules of thumb applied to a square footage, and some are general contractor estimates built from internal databases rather than current market pricing. These approaches can be useful for early feasibility, but they are not the same as a budget grounded in what qualified subcontractors are actually willing to do the work for today. Subcontractors bid to a defined scope of work. That scope comes from construction drawings: architectural, structural, civil, mechanical, electrical, plumbing, landscape, and specialty consultant documents that together describe every element of the project. When those drawings are incomplete, or when they exist only as a schematic design or early design development set, subcontractors cannot give a firm price. They may provide a qualified bid with unit pricing and stated assumptions, or a number with caveats tied to specific conditions. But they are not going to lock in pricing for work that has not been fully detailed on the drawings.

The Timing Problem: During the early phases of design, when you most want to know what the project will cost, the information needed to answer that question is not fully developed. Your architect is developing the design. Your structural engineer has not yet fully designed and engineered the foundation system. Your MEP consultants have not yet fully sized the systems and developed all engineering and conformance with Title 24. The drawings are evolving, and each evolution changes the scope that subcontractors would be pricing. The ranges you may receive from your general contractor at this stage are planning-level estimates, useful for feasibility decisions but not construction budgets.

Even when the drawings are complete, there are unknown conditions that no set of documents can fully resolve. A project can have a full set of structural drawings showing retaining walls, piles, and grade beams. During foundation work, drilling the first caisson reveals groundwater that was not indicated in the geotechnical report. Bedrock turns out to be six feet deeper than the closest boring hole predicted. During a renovation, opening an existing wall reveals dry rot, improper framing, or mechanical and plumbing systems that have to be relocated to accommodate the new design. Each of these unforeseen conditions changes the cost, and none of them could have been priced with certainty in advance. This is one of the reasons that well-structured budgets include contingencies for unforeseen conditions, and why how those contingencies are managed matters as much as the number itself.

The Reality of Unknown Conditions: The question is not whether there will be unknowns, but how they are managed when they appear. That depends on your delivery method, your contract structure, the contingencies built into the budget, and the quality of the pre-construction work that went into developing it. The better the pre-construction process, the smaller the gap between the budget and the final cost. But the gap never goes to zero, because the physical world does not conform perfectly to drawings.

The rest of this page gives you the planning ranges and the context to interpret them. It is worth understanding the difference between a planning range and a construction budget, because the distance between them is where the pre-construction process adds the most value.

How a Construction Budget Actually Works

A construction budget has an internal structure that most owners have not had reason to see before their first project. Understanding that structure changes the way you evaluate cost, and it changes the questions you ask your builder.

Hard Costs: The Direct Cost of Building

Hard costs are the direct costs of building. This is the money that flows to subcontractors, material suppliers, and equipment vendors for the physical construction of the project. It also includes direct-purchase materials and any work self-performed by the general contractor's own labor force, though self-performed labor can live either within the individual trade categories or within general conditions depending on the scope and how the contractor structures their work.

Hard costs are organized by CSI division under the MasterFormat framework, which is the standard classification system the industry uses to define scope, structure specifications, and organize bids. On a large residential project, this translates into 20 to 40 distinct trade packages, each competitively bid and individually contracted. Each trade contract carries a defined scope of work, and the construction manager's job is to ensure those scopes fit together without gaps or overlaps so that the complete project is covered and nothing falls between the cracks.

Think of hard costs in four categories. The first is the site: all of the site development, improvements, retaining walls, soil removal and recompaction, drainage, underground utilities, and the civil infrastructure that supports and surrounds the building. The second is the shell and core: the foundation, structural systems, structural frame, building envelope, and the primary mechanical, electrical, and plumbing systems that serve the building. The third is the interiors: the finishes, fixtures, millwork, and finish-level MEP connections that define the character and livability of the home. MEP systems straddle the shell/core and interiors categories, since rough-in is part of the shell and core but trim-out and finish connections are part of the interiors. The fourth is specialties: audiovisual systems, home automation and control, customized equipment, entertainment systems, and other technology-driven scope that often falls outside traditional trade categories and requires dedicated integration contractors.

General Conditions: The Cost of Managing the Build

General conditions are the project-specific costs of managing and supporting the construction process. This is not profit, and it is not corporate overhead. General conditions cover what it takes to run a complex jobsite: the superintendent who manages day-to-day operations, project management, temporary facilities (job trailers, temporary power and water, portable sanitation), jobsite safety and OSHA compliance, temporary fencing and security, project scheduling and administration, clean-up and debris removal, and the logistics coordination required to keep trades sequenced properly.

On a straightforward project, general conditions might run 8-12% of hard costs. On complex projects with long durations, difficult site access, or significant coordination requirements, general conditions can push to 15% or higher. Hillside projects in Los Angeles, where material delivery may require crane operations, where access roads limit truck sizes, and where the superintendent is managing work on a slope with constant erosion control requirements, consistently push toward the higher end of that range.

On projects we manage, general conditions funds a full-time superintendent running the site every day, a project manager coordinating budget, schedule, and communications, and the logistics infrastructure required for a safe, organized, productive jobsite. When general conditions is underbudgeted, the first thing that typically gets cut is supervision. A superintendent starts splitting time between two projects instead of one. Nobody is on site when the tile installer has a question about the layout. The framing crew stains the hardwood the wrong color because the super was at the other job when the stain samples were approved. These are not hypothetical scenarios. They are among the most common sources of quality problems on residential projects, and they are almost always traceable to insufficient management investment. The difference between a well-supervised project and one that is not shows up in the quality of the finished product, the number of items on the punch list, and whether the project finishes on schedule or runs months over.

Where the Value Lives
The temptation for owners is to view general conditions as a place to cut. But general conditions is where the quality of construction management is most visible. A project with sufficient general conditions investment is typically a clean, organized, well-kept jobsite where trades are properly sequenced, materials are staged efficiently, and safety and erosion control are actively maintained. Good project management and supervision results in higher quality outcomes, properly coordinated trades, better management of unforeseen costs and change orders, and higher overall productivity on site.

Insurance

The general contractor's insurance program on a residential project typically includes general liability and workers' compensation coverage, typically running between 1% and 2% of hard costs depending on the program structure and carrier. On a Construction Manager at Risk (CMAR) engagement, professional liability coverage should also be carried, since the CM is providing professional services during pre-construction that carry advisory responsibility beyond standard general contracting.

Builder's risk insurance, which covers the structure under construction against damage from fire, wind, theft, and other covered perils, is typically the owner's responsibility, not the contractor's. The owner purchases this policy, often through the same broker handling their permanent property insurance, and it converts to a standard homeowner's policy at project completion. Builder's risk typically needs to be coordinated with the general contractor, as the carrier's agents will want to see the progression of the project, confirm that safety measures are in place, and verify that the property is properly secured. In high-fire-risk areas, builder's risk has become more expensive and more difficult to place, which is worth discussing with your insurance broker before construction begins.

Fee

The construction management or general contractor fee is the builder's compensation for managing the project. Fee is typically determined by the complexity of the project, the scope and scale of the work, and market competition. Fee structures vary by delivery method and contract type. On a cost-plus arrangement, the fee is transparent. On a lump-sum contract, it is embedded in the contract price. The fee compensates for the builder's expertise, risk assumption, and the organizational infrastructure required to deliver a complex project.

Fee should be evaluated in context. Pre-construction services are typically a separate engagement with their own fee structure, not part of the construction management fee. Project management and supervision resources are funded through general conditions, not fee. When evaluating a builder's overall cost structure, the important question is not just the fee percentage but the complete picture: what level of pre-construction is included, what management resources are funded through general conditions, and what organizational support the fee itself covers.

The Overhead Load

When you add general conditions, insurance, and fee together, you get the "overhead load" or "GC load." On complex residential projects in Los Angeles, this combined load typically runs around 20% on top of direct hard costs. Some projects come in under that, some above, depending on duration, complexity, and the scope of management services included.

~20%
Typical GC Load
(GC + Insurance + Fee)
8-15%
General Conditions
Range by Complexity
1-2%
GL + Workers' Comp
Insurance

This overhead funds the infrastructure that makes a complex project work. The right level of general conditions investment supports better coordination, fewer surprises, and a smoother construction process overall. Owners who understand this make better decisions about how to structure their project, which is one of the reasons delivery method selection is important.

Soft Costs: The Budget Outside the Construction Contract

When you hear a construction cost number, that number typically represents hard costs plus the GC load. But the total project investment includes a separate layer of cost that sits outside the construction contract: the design, engineering, consulting, regulatory, and permitting costs required to take a project from concept through completion. These are soft costs, and on custom residential projects in Los Angeles, they consistently represent one of the most common sources of budget surprise for owners who plan around the construction number alone.

15-25%+
Typical Soft Cost Load
as % of Construction Cost
$750K-$1.25M+
Soft Costs on a
$5M Construction Budget

An owner budgeting $5M for construction should be planning for $6M to $6.5M or more in total project investment when soft costs are included. On complex projects with extensive consultant teams, the soft cost load can push even higher. Understanding these categories and their scale early in planning prevents the situation where an owner has a realistic construction budget but an unrealistic total project budget.

Architecture and Design

Architecture fees on custom residential projects in Los Angeles typically run 8-15% of construction cost, depending on the firm, project complexity, and the scope of services provided. That range covers schematic design through construction administration, meaning the architect's involvement from initial concepts through final inspection. More complex projects, prominent firms, and projects requiring extensive design iteration push toward the higher end. Some firms charge fixed fees; others work on a percentage basis with the fee adjusting as the construction budget develops. Either way, on a $5M construction budget, architecture fees of $400,000 to $750,000 are realistic.

When a separate interior designer is engaged, their fees add to the design cost. This is common on high-end projects where the architect handles the building design and an interior designer handles finish selections, furniture, custom fixtures, and the overall interior program. Interior design fees vary widely but can add another 10-15% of the interior finish budget on top of the architecture fees.

Landscape architecture is another design discipline that carries its own fee structure. On properties with significant exterior programs, including pools, sport courts, outdoor kitchens, extensive hardscape, and designed planting, landscape architecture fees and the documentation they produce can be substantial. The landscape architect's scope often includes civil coordination for drainage and grading, irrigation design, lighting design, and detailed planting plans that collectively form a second set of construction documents for the site work.

Engineering and Consulting

The engineering consultants on a residential project are typically separate firms retained by the architect or directly by the owner. On a complex project, the consultant team can include structural engineering, civil engineering, geotechnical engineering, surveying, MEP engineering, Title 24 energy compliance, HERS testing, and CalGreen documentation. Each carries its own fee.

Geotechnical reports deserve specific attention because they directly influence the foundation design and therefore the construction cost. For hillside properties or sites with complex soil conditions, a geotech investigation can run $15,000 to $40,000 or more depending on the number of borings, the depth of investigation, and the complexity of the analysis. On sites where slope stability, ancient landslide deposits, or groundwater are factors, supplemental investigations and ongoing geotechnical observation during construction add to that cost. This is not a place to cut corners. The geotech report is the foundation for the foundation design, and incomplete investigation is one of the most common sources of unforeseen cost during construction. Our foundation systems page covers what a complete geotechnical investigation includes and how each finding translates into construction cost. For a broader view of site investigation requirements, see our guide to lot due diligence in Los Angeles.

Special Inspections and Testing

Special inspections and materials testing are code-required on most projects of any complexity and are the owner's cost, not the contractor's. These include concrete testing (cylinder breaks for compressive strength), structural steel welding inspection, reinforcing steel placement inspection, soils compaction testing, shoring monitoring, and post-tensioning tendon stressing verification. On a project with significant concrete and steel work, special inspection costs can run $50,000 to $150,000 or more over the life of the project. The building department requires proof of passing inspections before approving concealment of the work, so these costs are not optional.

Permits, Fees, and Regulatory Costs

Permit and plan check fees on a large residential project in Los Angeles can run $100,000 to $300,000 or more depending on the project valuation that LADBS uses to calculate fees. School fees, assessed by LAUSD as a developer fee on new construction, are charged per square foot of new building area and add to the total. These fees are established by the jurisdiction and are not negotiable.

Utility connection fees and infrastructure upgrades are another category that can carry significant and sometimes unexpected cost. DWP (power and water), Bureau of Sanitation (sewer), and SoCalGas each have their own connection requirements and fee structures. On some properties, the existing utility infrastructure is insufficient to serve the new construction, and upgrades to transformers, service lines, or sewer laterals are required at the owner's expense. These upgrades can add tens of thousands of dollars and, in some cases, months to the schedule if utility company review and construction timelines are involved.

Expediting services, when used, add a further soft cost. An experienced permit expediter who manages the plan check process, coordinates corrections with the design team, and maintains relationships with the building department can reduce permitting time significantly. On complex projects where permitting timelines directly affect the construction schedule, expediting is often a worthwhile investment.

Jurisdiction Matters
Construction costs and timelines vary by jurisdiction within the greater Los Angeles area. The City of Los Angeles (LADBS), Beverly Hills, Santa Monica, Malibu, West Hollywood, and unincorporated LA County each have their own building departments, planning processes, fee structures, and regulatory requirements. Projects in the Coastal Zone face additional review by the California Coastal Commission. Projects in hillside overlay zones face additional planning review. Beverly Hills and Malibu are generally recognized as having more complex and time-intensive permitting processes than the City of LA, which affects both soft costs and project schedule. When budgeting soft costs, understanding which jurisdiction governs your property is an important early step. For more on the permitting landscape, see our Los Angeles permitting guide.
The Total Project Investment
When evaluating a construction budget, remember that the construction cost is not the total project cost. Soft costs of 15-25% on top of the construction budget are typical on custom residential projects in Los Angeles, and complex projects with extensive consultant teams, difficult permitting, and significant utility work can push higher. Plan your total project budget accordingly, and discuss soft cost projections with your architect and construction manager early in the design process.

Contingency: Professional Risk Management, Not Waste

A budget with no contingency is not lean; it is unrealistic. Every construction project carries uncertainty, and contingency is the mechanism for managing that uncertainty responsibly. The question is not whether to carry contingency, but how it is structured, who controls it, and how it is managed when it is used.

There are three distinct types of contingency, each covering a different category of risk. Understanding the differences matters because each type has a different purpose, a different appropriate percentage, and a different party who should control it.

Design Contingency

Design contingency covers scope that is anticipated but not yet fully detailed in the drawings. This is most relevant during design development, when the design direction is set but specifications, construction details, and systems engineering are still being resolved. At this stage, the budget is based on a combination of competitive pricing for defined scope and informed estimates for scope that is directionally understood but not yet documented in enough detail for subcontractors to price firmly.

Design contingency typically runs 5-10% during design development and should reduce as construction documents are completed and subcontractor bids replace estimates. By the time a full set of construction documents is priced and a GMP is established, design contingency should be largely absorbed into firm pricing. It does not always reach zero, however. A number of design decisions are typically finalized during the shop drawing and submittal process after construction begins, and some contingency should remain to cover those refinements. If significant design contingency remains at GMP beyond what is attributable to outstanding submittals, it usually means the documents are not yet complete enough to support a reliable budget.

Construction Contingency

Construction contingency covers conditions discovered during construction that could not have been anticipated from the drawings or pre-construction investigations. Subsurface conditions that differ from the geotechnical report. Concealed conditions in renovation work, such as structural deficiencies, water damage, or code-noncompliant framing hidden behind finished surfaces. Material availability issues that require substitutions. Weather events that cause damage or delay beyond normal expectations.

For new construction on a well-investigated site with complete documents, construction contingency of 5-10% is a responsible planning range. For renovation work where existing conditions are partially unknown, 10-15% or higher is appropriate. The appropriate level of construction contingency depends not only on the project conditions but also on the quality of the budget development process itself: how complete the plans were at the time of pricing, how thoroughly subcontractor bids were solicited and leveled against those plans, and how allowances were structured for scope that was not fully detailed. A budget built from a rigorous buyout process with competitive bids against complete documents warrants less contingency than a budget assembled from preliminary pricing against an incomplete set. On a CMAR project, contingency usage is transparent and documented. Every draw against contingency is supported by documentation of the condition encountered and the cost impact. On a lump-sum contract, contingency is embedded in the contract price and invisible to the owner, which means you are paying for it either way, but in one structure you can see how it is being used and in the other you cannot.

Owner Contingency

Owner contingency is a separate reserve held by the owner, not the contractor, for owner-directed changes, upgrades, and scope additions during construction. Most projects experience some level of owner-directed change. An owner visits the site during framing, sees the space taking shape, and decides to add a feature or upgrade a specification. The kitchen design evolves after cabinetry is already in fabrication. A material that was selected during design turns out to look different in the actual space than it did in the sample, and the owner wants to change direction.

These are not failures of planning. They are a realistic acknowledgment that decisions evolve during a 12-to-24-month process where the owner is seeing the project develop from drawings into physical space. A responsible planning range is 5-10% of the construction budget held in reserve for owner-directed changes. Owners who do not carry this reserve often find themselves making stressful decisions about whether to proceed with a change they want or absorb the cost impact without a dedicated budget for it.

5-10%
Design Contingency
(Reduces as Docs Complete)
5-15%
Construction Contingency
(New Build to Renovation)
5-10%
Owner Contingency
(Held by Owner)
Contingency Is Not Padding
Contingency is professional risk management. A budget without contingency is a budget that assumes everything will go exactly as planned, which is not how construction works in the physical world. The difference between a well-managed project and a stressful one is often the quality of the contingency planning, not whether contingency was needed. On a CMAR project, contingency is carried transparently, documented when used, and returned to the owner if unspent. That structure gives you both protection and accountability.

Site Development: Often the Largest Variable

If there is one category that consistently surprises owners, it is site development. On a flat lot in a developed neighborhood with standard soils, site development is a manageable line item. On a hillside property in Los Angeles, it is one of the most significant cost drivers on the project and can represent 25-30% or more of the total budget.

What Site Development Includes

Site development covers everything required to prepare the property for construction and complete the exterior improvements. On a complex LA project, that scope can be more extensive than anticipated.

It starts with the ground itself: surveying and civil engineering to establish the site topography, erosion control systems required by the city when you pull a grading permit, demolition of existing structures, and the earthwork package. Earthwork includes grading, excavation, soil export (which on hillside sites can mean hundreds of truck loads on narrow canyon roads), soil import, and removal and recompaction of existing fill soils to achieve a competent bearing surface underneath the new structure. A competent bottom can mean bedrock at depth, or it can mean a removed and recompacted fill layer that meets the geotechnical engineer's requirements for supporting the foundation. Achieving that condition is a critical milestone that can involve significant cost if existing soils need to be over-excavated and replaced with engineered fill.

Then there is the structural and civil sitework: retaining walls, site drainage systems including stormwater management required under the city's Low Impact Development (LID) program, subsurface cisterns or other stormwater retention systems, sewer connections, utility trenching, protected tree relocations or removals required under the city's tree preservation ordinance, and all of the underground infrastructure that has to be in place before the building goes vertical.

Finally, there is everything that defines the finished site: hardscape and site concrete for driveways, walkways, patios, and pool decks. Site masonry and stonework. Landscape and irrigation. Site electrical for exterior lighting, gate systems, and EV charging. Site plumbing for pool equipment, fountains, and irrigation connections. Site waterproofing for below-grade retaining structures. On a property with a pool, sport court, guest house, and extensive landscape architecture, these finish-level site trades can rival the cost of the building's interior finishes.

Why the Range Is So Wide

$200-500K
Site Development
Flat Lot, Standard Soils
$1-5M+
Site Development
Complex Hillside
25-30%+
Site Development as %
of Total (Hillside)

The variables include slope angle and stability, various subsurface conditions such as rock, expansive clay, fill soils, and ancient landslide deposits, volume of soil to be moved, retaining wall height and structural requirements, whether shoring is needed to protect adjacent properties, access constraints that limit equipment size and delivery logistics, stormwater management requirements, and the scope of hardscape, landscape, and amenity improvements.

This is the category that makes it impossible to generalize about construction costs in Los Angeles. Two projects with identical houses can have site development costs that differ by millions of dollars based solely on the lot they sit on. On a hillside project with retaining walls at multiple elevations, the site concrete package alone can be a six-figure trade scope, sometimes larger than the entire interior finish budget on the same project.

Pools, Sport Courts, and Site Amenities

On most high-end residential projects in Los Angeles, the exterior amenity program is a significant part of the budget. Pools, spas, sport courts, outdoor kitchens, and motor courts are standard expectations on properties in these markets, and owners consistently want to understand what these items cost. These costs are typically part of the site development budget, but they deserve separate attention because they represent some of the largest individual line items outside the building itself.

Swimming Pools and Spas

Custom gunite pools on high-end residential projects in Los Angeles start at approximately $150,000 and can exceed $500,000 depending on size, site conditions, and features. That range covers the pool shell, equipment, basic decking, and standard finishes. It does not typically include extensive surrounding hardscape, landscape, or site structures like pool houses or cabanas, which are separate scope items.

Several features push pool costs well beyond the base range. Vanishing-edge (infinity) pools require specialized structural engineering, a concealed catch basin below the edge, high-performance recirculation pumps, and precision construction tolerances that push the total well above a standard pool configuration. On hillside properties with views, the vanishing edge is often the centerpiece of the exterior program, and the structural and waterproofing requirements to build it on a slope add further cost. Integrated spas, perimeter-overflow designs, water features, fire features, and pool automation systems each add to the total. On properties where the pool is built into a hillside or requires significant excavation, the site preparation cost for the pool alone can rival the cost of the pool itself.

Pools, spas, and water features are typically engineered separately by specialists who focus exclusively on aquatic design and construction. Their drawings are developed as a standalone set of bid documents that pool subcontractors price independently from the main building trades. This is a separate engineering scope and a separate bidding process from the building structure, and it should be coordinated early with the architect and general contractor to ensure the pool design integrates properly with the site civil work, structural systems, and utility infrastructure.

Pool/Spa Scope Typical Cost Range Notes
Custom gunite pool $150K-$300K Standard configuration, flat lot, quality finishes, equipment, and basic decking
Vanishing-edge pool $400K-$750K+ Adds catch basin, structural engineering, high-performance pumps; hillside sites push higher
Integrated spa $50K-$60K+ When built as part of the pool; standalone spas cost less but require separate equipment
Pool automation $20K-$30K Smartphone-controlled temperature, lighting, chemical management, and cleaning cycles

Sport Courts

Residential sport courts are common on larger properties in Pacific Palisades, Beverly Hills, and Bel Air. A regulation tennis court requires approximately 7,200 square feet of playing surface, and the total installed cost for an outdoor hard court with acrylic surfacing, fencing, lighting, and drainage typically runs $120,000 to $250,000 in the LA market, depending on site preparation requirements and finish level. Multi-sport courts designed for basketball, pickleball, and volleyball on a smaller footprint typically run $75,000 to $175,000 for a full-court configuration with quality surfacing, goals, nets, fencing, and lighting. Site preparation on properties with slopes or poor drainage can add significantly to these numbers, as can retaining structures required to create a level pad on sloped terrain.

Other Site Amenities

Amenity Typical Cost Range Notes
Outdoor kitchen $75K-$250K+ Built-in grill, countertops, cabinetry, plumbing, gas, electrical; stone and steel construction
Guest house / pool house $400K-$800K+ Permitted habitable structure with kitchen, bath, HVAC; costs mirror main house per SF
Motor court / auto gallery $200K-$600K+ Heated slab, specialty flooring, climate control, lighting, security; above-grade vs. subterranean
Landscape architecture
(hardscape + softscape)
$200K-$1M+ Comprehensive planting, irrigation, hardscape, site lighting, drainage; highly variable by property size
Amenity Costs Compound: Owners sometimes plan the construction budget around the house and treat the exterior program as an afterthought. On a property with a pool, spa, sport court, outdoor kitchen, guest house, and designed landscape, the combined site amenity cost can easily reach $1M to $2M or more, which is often 20-30% of the total project budget. Identifying and budgeting these costs during design keeps the total project budget aligned from the start.

Foundations and Structural Systems

Foundation Design Follows Geotechnical Reality

Foundation design evolves directly from the geotechnical conditions of your specific site, as documented in a soils report prepared by a licensed geotechnical engineer. This report is one of the first critical documents that shapes your construction budget, and it should be commissioned early in the design process.

In Los Angeles, you may encounter stable bedrock at shallow depth, expansive clay soils that swell and shrink with moisture changes, fill soils from prior grading that may not be properly compacted, ancient landslide deposits that require special engineering, high groundwater, or seismic fault proximity that influences structural design criteria. Often you encounter several of these on the same site.

Each condition drives a different foundation solution. A house on stable rock with shallow bedrock might use conventional spread footings, the simplest and least expensive foundation type. A house on a hillside with expansive soils and slope stability concerns might require drilled piles extending 20 to 50 feet to bedrock embedment, connected by grade beams that span between the piles. A house near a slope requiring excavation below adjacent properties might need a soldier pile and lagging system or tieback shoring, depending on the design and site conditions.

$150-400K
Conventional Footings
Flat Lot (3,000-6,000 SF)
$500K-1.5M+
Piles + Grade Beams
Hillside

This is where unforeseen conditions often have the most impact. The geotechnical report is based on a limited number of boring holes, and we almost always recommend additional borings. What lies between those borings is an educated prediction, not a guarantee. When actual conditions differ from the report, the foundation cost changes. On a recent hillside project we managed, the foundation system alone represented approximately 25% of the total hard cost before any above-grade construction began. The difference between a flat-lot foundation at $120,000 and a hillside caisson system at $400,000 or more is the single biggest variable in per-square-foot cost between project types.

Structural Framing

Above the foundation, the structural framing system is the next major cost driver. Residential projects in Los Angeles typically use wood framing, structural steel, reinforced concrete, or hybrid systems combining two or more materials.

Wood framing remains the most cost-effective structural system and is appropriate for many projects. But on larger or more architecturally ambitious homes, particularly those with long spans, cantilevered volumes, or expansive glass walls, structural steel or concrete becomes necessary. The architect's design intent and the structural engineer's requirements together determine which system is appropriate.

Structural steel adds significant cost compared to wood framing, both in material and in the specialized labor required for fabrication and erection. Steel pricing has been volatile since 2020, and the full cycle of shop drawing reviews, revisions, and fabrication can stretch to four to six months on residential projects. On projects where steel or concrete is the primary framing system, the structural frame alone can represent 15-25% of the total hard cost.

Subterranean Construction

Subterranean space is increasingly common on high-end residential projects in Los Angeles, driven by a combination of zoning constraints that limit above-grade building area, the desire for amenity spaces that benefit from controlled environments, and on hillside properties, the practical reality that much of the building footprint sits partially below grade. Subterranean garages, home theaters, wine cellars, wellness rooms, gyms, and storage vaults are standard program elements on high-end residential projects in this market. When they are part of the scope, they are among the most significant cost drivers on the project.

Why Subterranean Space Costs More

Building below grade is fundamentally different from building above grade. The cost differential is driven by several factors that compound on top of each other. Excavation is the starting point: removing soil from below the planned structure, exporting it off-site (which on hillside properties can mean hundreds of haul trucks on restricted-access roads), and achieving a competent excavation bottom that meets the geotechnical engineer's requirements. On a two-level subterranean garage, the excavation scope alone can represent a six- or seven-figure line item.

Then there is the structural system. Subterranean space requires reinforced concrete walls, slabs, and often columns designed to resist lateral earth pressure from the surrounding soil, hydrostatic pressure from groundwater, and the seismic loads that are part of every structural design in Los Angeles. The concrete and reinforcing steel quantities for a below-grade structure are significantly greater than for an equivalent above-grade space. On sites where groundwater is present, dewatering systems may be required during construction to keep the excavation dry enough to work in, adding cost and schedule risk.

Waterproofing is critical and expensive. Below-grade waterproofing systems on subterranean construction typically include membrane waterproofing on all foundation walls and the slab, waterstop at every concrete cold joint, sub-slab drainage and vapor retarder systems, and often a redundant drainage system (French drain or drainage board) to relieve hydrostatic pressure before it reaches the membrane. A failure in below-grade waterproofing is one of the most expensive problems to fix after the fact, because the waterproofing system is buried behind concrete and finishes that would have to be removed to access it. This is an area where the quality of detailing, materials, and installation supervision directly affects long-term performance.

MEP systems for habitable subterranean space add further cost. Below-grade rooms require dedicated ventilation systems for air quality, sump pumps and emergency drainage, and often dedicated HVAC zones. A subterranean theater or wine cellar has specific temperature and humidity requirements that standard residential systems do not accommodate. Fire suppression and emergency egress requirements also apply to habitable below-grade space, and these systems need to be designed and coordinated during the document phase.

$800-$1,200+/SF
Subterranean Space
All-In Construction Cost
$1M-$3M+
Two-Level Subterranean
Garage (Typical Range)

These costs reflect the combined impact of excavation, shoring, structural concrete, waterproofing, MEP systems, and the extended schedule that below-grade work adds to the project. A bare subterranean space used primarily for storage or utility access might come in at the lower end of that range, around $800/SF, but a finished living space with bedrooms, bathrooms, and full MEP systems is typically $1,000/SF or more. On hillside projects where the basement is excavated into a slope, the below-grade living space is typically the most expensive square footage in the entire project, often running $1,200-$1,400/SF when you account for excavation, shoring, structural concrete, waterproofing, and full interior finishes. An owner considering a 2,000-square-foot subterranean level with finished living space should be budgeting $2M to $2.5M or more for that scope, depending on site conditions and the level of finish. On properties where zoning limits above-grade floor area but permits subterranean space, the economics of building down versus buying a larger lot are worth analyzing carefully with your architect and construction manager early in the process.

Subterranean Space and Your Budget
Subterranean construction can easily add seven figures to a project budget. Finished below-grade living space typically costs $1,000/SF or more, which is 1.5 to 2.5 times the cost of equivalent above-grade space due to excavation, structural requirements, waterproofing, and specialized MEP systems. If your program includes a subterranean garage, theater, or other below-grade space, it should be identified and budgeted during schematic design, not treated as a simple extension of the building footprint.

Building Envelope

The building envelope is everything that separates the interior conditioned space from the exterior: the roof, walls, windows and doors, and the waterproofing systems that keep water out of the structure. In Los Angeles, the combination of seasonal rain, Santa Ana winds, marine air exposure at coastal and canyon elevations, and wide temperature swings means that building envelope detailing requires careful attention, particularly at material transitions and penetrations where water intrusion risk is highest. Envelope failures that might take years to manifest in a drier climate can develop quickly in properties exposed to wind-driven rain and salt air.

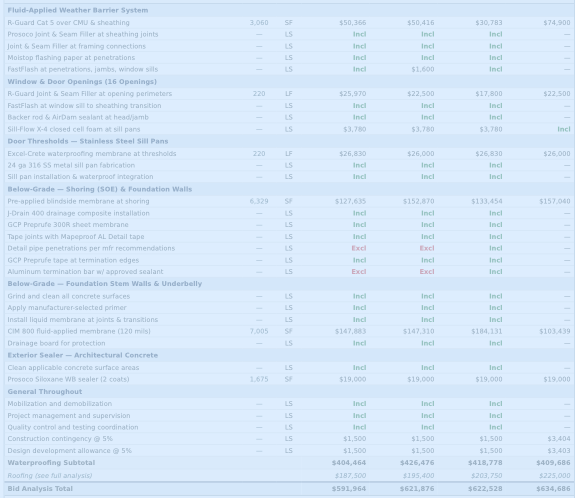

Waterproofing

Below-grade waterproofing protects foundation walls, retaining walls, and slabs from moisture intrusion. Above-grade waterproofing protects the building envelope at transitions, penetrations, and material interfaces. On a hillside project with below-grade spaces, waterproofing is a critical scope that includes membrane systems on foundation walls, waterstop at concrete cold joints, sub-slab vapor retarders, French drain systems to relieve hydrostatic pressure, and fluid-applied or sheet-applied membranes at the building exterior.

Waterproofing costs vary with the extent of below-grade construction and the complexity of the building envelope. On a project with significant below-grade space and complex site drainage, total waterproofing costs can run $75,000 to $200,000 or more. Given how critical this scope is, a third-party waterproofing inspector is often recommended to verify proper installation at each stage before systems are concealed. Water intrusion in a finished basement or behind finished walls is one of the most expensive problems to address after the fact, which is why the waterproofing scope deserves careful attention during both budgeting and construction.

Glazing Systems

On high-end residential projects in Los Angeles, glazing is a significant cost category. Architects designing for the Southern California climate frequently specify expansive glass walls, large-format sliding or folding door systems, and floor-to-ceiling windows that connect interior spaces to outdoor living areas.

Glazing Level Typical Cost Range What It Includes
Standard aluminum $150K-$300K Quality residential windows and doors in standard configurations (4,000-6,000 SF home)
High-performance $400K-$800K+ Fleetwood, Western Window Systems, European tilt-turn; large-format panels, minimal sightlines (5,000-10,000 SF home)
Per opening (large) $30K-$80K Multi-panel sliding systems 20+ feet wide with top-tier door and window systems, installed

Glazing decisions made during design have a direct impact on the construction budget, and the coordination involved goes well beyond selecting a product. Glazing systems affect structural design (headers, moment frames, and connection details must accommodate the weight and span of large panels), Title 24 energy compliance (glass performance values drive the energy model), waterproofing detailing at every opening, and the construction schedule (lead times on high-performance systems can run four to six months from approved shop drawings to delivery). Late changes to glazing selections can cascade into structural modifications, energy recalculations, and schedule delays. Early coordination between the architect, contractor, and glazing manufacturer is one of the highest-value activities in pre-construction.

Roofing and Exterior Finishes

Roofing systems range from composition shingle through standing-seam metal, clay or concrete tile, natural slate, and flat-roof membrane systems. Many contemporary LA homes use a combination of flat and sloped roof systems, each with its own cost profile. On flat roofs, thermoplastic membrane systems such as Sarnafil and FiberTite offer significantly better performance and longer warranties than traditional built-up or torch-down roofing, though they come at a higher installed cost.

Exterior finishes include stucco (still the most common in LA residential construction), natural stone, manufactured stone veneer, wood siding, metal panel systems, and fiber cement. On projects where the architect specifies mechanically fastened natural stone cladding, the cost escalation is significant: the stone itself, the engineered clip and anchor systems, and the specialized installation labor combine to make stone-clad exteriors one of the most expensive finish categories on a residential project. The material selection, combined with the architectural detailing at transitions and interfaces, drives both cost and long-term maintenance requirements. This is an area where the range between approaches is so wide that meaningful cost guidance requires a complete set of drawings and specifications.

Mechanical, Electrical, and Plumbing

MEP systems are the infrastructure of the building. They are largely invisible once the walls and ceilings are closed, which is one reason their cost is often underestimated. On a well-engineered custom home, MEP systems can represent 20-25% of the building hard cost, and on projects with sophisticated automation or complex HVAC requirements, the percentage can go higher.

HVAC

Heating, ventilation, and air conditioning on a high-end residential project goes well beyond a standard forced-air system. Zoned systems with independent temperature control, high-efficiency equipment, dedicated systems for wine storage or server rooms, and integrated ventilation for indoor air quality all increase HVAC costs. On homes with radiant floor heating or other specialty approaches, costs escalate further. A straightforward ducted system for a 5,000 SF custom home might run $80,000 to $150,000 installed. A multi-zone high-efficiency system with radiant components and integrated controls can run $200,000 to $400,000 or more.

Electrical and Low-Voltage

Electrical scope includes power distribution, lighting, and lighting control systems. Low-voltage and home automation are typically a separate package and include structured data wiring, audio/visual, security, access control, home automation, motorized shading, and landscape lighting control. The low-voltage and automation scope is where costs on high-end projects diverge most dramatically from standard residential construction. A standard home might have $15,000 to $25,000 in low-voltage wiring and basic networking. A fully integrated smart home with a platform like Crestron or Savant, distributed audio throughout, a dedicated theater, motorized shading on every window, and integrated security can exceed $500,000, driven by the complexity of system integration, programming, and the infrastructure that has to be in place before walls close.

Scope Typical Cost Range
Electrical package (power, lighting, standard fixtures) $100K-$200K
Low-voltage and automation (Crestron/Savant/Control4, distributed audio, theater, motorized shades, integrated security) $400K-$800K+

Both systems require significant coordination during design. The full low-voltage scope needs to be developed and pre-wire completed before walls are closed. Conduit pathways, equipment locations, and infrastructure requirements need to be resolved before framing is complete. Late changes to automation scope can be particularly disruptive and expensive as change orders on residential projects.

Plumbing and Fire Suppression

Plumbing costs are driven by the number of fixtures, the quality of fixtures selected, and the complexity of the distribution system. The labor to install a standard faucet and a designer faucet is roughly the same. The difference is in the fixture cost, and when that difference is multiplied across every faucet, showerhead, valve, toilet, and tub in the house, the total adds up quickly.

Residential fire sprinkler systems are required by code on most new construction in Los Angeles, typically running $3 to $6 per square foot for a standard residential system. Fire suppression is one of the most cost-effective safety investments in a residential project. Residential fire sprinkler systems are designed to provide safety for occupants to exit the residence. They are not designed to protect a structure from an external wildfire event, which is an important distinction for properties in high-fire-risk areas.

Interior Finishes: Where the Range Is Widest

Interior finishes are the most variable cost category on any residential project because the range of available materials and craftsmanship levels is extremely broad. At one end, you have a finished drywall interior with standard trim. At the other, you have full millwork wall paneling, wainscoting, custom casework, and detailed architectural trim throughout. The distance between those two approaches, multiplied across an entire house, creates the widest cost range of any category on the project.

What Drives Interior Finish Costs

Millwork and cabinetry is typically the largest single finish trade. That scope covers kitchen cabinetry, bathroom vanities, built-in storage, wall paneling, interior doors, and architectural trim. On a high-end project, custom millwork is designed by the architect or interior designer and fabricated to the specific dimensions of each space, which is a significantly different cost proposition than selecting from a manufacturer's catalog.

Surface materials come next: countertops, flooring, and tile and stone work for bathrooms, feature walls, and fireplace surrounds. Then there are the finish trades that complete the picture: paint and specialty wall finishes, hardware, and specialty items like custom glass, architectural metalwork, and decorative lighting. Individually, some of these seem like small line items. In aggregate, across a large house, they represent a significant portion of the finish budget.

Finish Level Framework

Finish Level Cost/SF What It Means
Custom $250-$400/SF Quality materials, semi-custom cabinetry, natural stone or engineered quartz countertops, engineered hardwood, established hardware brands
High-End $450-$600/SF Custom-fabricated millwork, imported stone, wide-plank solid hardwood, specialty plaster or lime wash, curated designer hardware
Top-Tier Custom $600-$1,000+/SF Uniquely selected and one-of-a-kind materials, slab-selected stone, top-tier European fixtures, custom door and window hardware, artisan finishes throughout

These finish-level decisions compound across every room in the house. A single bathroom might have $15,000 in tile or $80,000 in custom stone slabs depending on the material and installation complexity. Multiply that variation across six or eight bathrooms, a kitchen, living areas, and specialty spaces, and the total impact is measured in hundreds of thousands of dollars.

What Happened to Construction Costs After COVID

If you last built or renovated before 2020, the current cost environment will feel materially different. Several forces converged between 2020 and 2025 to reset the baseline, and while some pressures have eased, the overall cost structure has not returned to pre-pandemic levels.

Material Escalation

Lumber prices increased by over 300% at their peak in 2021 before partially correcting. Structural steel, reinforcing steel, copper, and concrete all saw significant price increases. As of early 2026, some material categories have normalized toward pre-pandemic pricing, but many have settled at levels 20-40% above 2019 prices. The volatility itself has become a factor, as subcontractors now build larger escalation contingencies into their bids to protect against future swings.

Labor Market Compression

Labor cost increases have been more persistent than material increases and have not shown signs of reversing. The construction labor market in Los Angeles was tight before the pandemic. The combination of workforce attrition during COVID shutdowns, an aging skilled labor force, reduced immigration, and strong demand has created sustained upward pressure on wages across virtually every trade. Skilled trade labor rates have increased 25-40% or more since 2019 across most disciplines, with some specialty trades seeing even larger increases. Unlike material prices, which have partially corrected from their peaks, labor costs have reset at a permanently higher level. This is one of the primary reasons why "costs will come back down" has not materialized the way many owners hoped.

Insurance Escalation

Construction insurance costs have increased substantially, driven by wildfire risk reassessment, increased claim severity, and carrier exits from the California market. For properties in or near PGRAZ zones, insurance availability and cost have become project-feasibility questions, not just budget line items.

Cost Escalation Over the Project Lifecycle

There is a practical timing issue that many owners do not anticipate. The planning-level budget developed during design development is based on pricing obtained at that point in time. But construction may not start for another 12 to 18 months, depending on the pace of document completion and permitting. During that interval, material costs can shift, labor rates can increase, and market conditions can change. A budget developed in 2025 may not hold in 2027 without an escalation allowance.

Well-structured budgets account for this by including an escalation contingency, typically 3-5% per year of anticipated delay between pricing and construction start. On a CMAR project, this is built transparently into the budget as a line item, and if construction starts on schedule and pricing holds, the unused escalation reverts to the owner. On a lump-sum contract, the contractor builds escalation risk into the contract price, but the owner has no visibility into the assumption or the ability to recover unused contingency. In a market that has seen residential construction costs increase over 40% in five years, escalation risk is not theoretical. It is one of the most practical arguments for aligning pre-construction timing with construction start, and for carrying realistic contingency when a gap exists.

The Palisades and Eaton Fire Impact

Post-Fire Market Pressure: The January 2025 fires destroyed thousands of structures and created a demand surge in an already-constrained market. Subcontractors already booked 6-12 months out now face additional demand from fire rebuilds, putting upward pressure on pricing across the entire LA market, not just for fire rebuild work. Material demand, labor competition, and evolving PGRAZ regulations all compound the effect. For properties evaluating existing foundations for reuse, see Fire-Damaged Foundation Certification. See Fire Rebuild & PGRAZ for the regulatory detail.

Schedule Drives Cost

Duration is one of the most direct cost drivers on any construction project, and it is one of the least understood by owners at the planning stage. General conditions are predominantly time-based. A project that runs 18 months instead of 12 carries 50% more superintendent time, temporary facilities, insurance, temporary power, portable sanitation, and site overhead. The construction cost per square foot did not change. The schedule changed, and the budget moved with it.

10-14 mo
Flat-Lot Custom Home
Typical Construction Duration
16-24 mo
Complex Hillside
Typical Construction Duration
24-30+ mo
Large-Scale Complex
Extensive Site + Amenities

These ranges assume permit in hand at the start of construction. The permitting process adds additional time upstream, which can range from a few months on a straightforward project to a year or more on complex projects requiring planning entitlements, variances, or Coastal Commission review. For more on that timeline, see our Los Angeles permitting guide.

What Extends a Schedule

Some schedule drivers are inherent to the project: site complexity, foundation depth, structural system fabrication time, and the sheer volume of work on a large project. These are accounted for in a well-developed construction schedule and reflected in the general conditions budget from the start.

Other schedule drivers are avoidable. Delayed owner decisions during construction create dead time that extends the schedule and increases general conditions cost. Finish selections that are not finalized before the relevant trades need to start work. Design changes that require re-engineering and revised submittals. Fixture and material choices that trigger procurement timelines the schedule did not account for. When these delays occur, subcontractors may demobilize and lose their place in the production sequence. Remobilizing them means re-scheduling around their other commitments, and the priority your project had on their calendar may not be available when you are ready to restart.

Long lead items are a specific and predictable schedule risk that should be managed during pre-construction, not discovered during construction. Structural steel fabrication typically carries a four-to-six-month lead time from approved shop drawings to delivery. Custom glazing systems can carry similar or longer timelines. Imported stone, custom millwork, and specialty fixtures all have procurement timelines that need to be identified early and orders placed in coordination with the construction schedule. A steel package that is not ordered until framing starts will create a schedule gap that costs money in general conditions even though the steel line item itself has not changed.

Schedule and General Conditions: General conditions are time-based, so construction duration has a direct effect on the budget. On a complex project, superintendent, project management, temporary facilities, and site overhead run $40,000 to $80,000 per month or more. Disciplined pre-construction that identifies long-lead items and decision milestones before construction begins is the most effective tool for keeping the schedule on track.

The Full Project Timeline: Concept to Move-In

The construction durations above represent only one phase of the total project timeline. Owners planning a custom home in Los Angeles should understand the full elapsed time from the decision to build through the day they move in, because the phases that precede construction often take as long as construction itself, and each phase carries its own costs.

Typical Project Phases and Duration
01Architect Selection + Programming1-3 mo
02Schematic Design2-4 mo
03Design Development3-6 mo
04Construction Documents4-8 mo
05Permitting3-12+ mo
06Construction10-30 mo
07Closeout + Move-In1-2 mo

On a moderately complex custom home, the design phase from initial programming through completed construction documents typically runs 9 to 18 months. Permitting in the City of Los Angeles adds another 3 to 6 months for a straightforward project, and considerably longer for projects requiring planning entitlements, variances, hillside review, or Coastal Commission approval. Beverly Hills and Malibu permitting processes can extend the timeline further.

When you add design, permitting, and construction together, a realistic timeline from the decision to build through move-in is 2.5 to 4 years for a custom home of moderate complexity, and 3 to 5 years or more for a large-scale complex project on a difficult site with complex permitting. Owners who understand this at the outset make better decisions about when to start, how to structure their financing, and how to manage the carrying costs of existing housing during the build.

2.5-4 yrs
Typical Total Timeline
Custom Home (Concept to Move-In)
3-5+ yrs
Complex Project
Hillside + Entitlements
9-18 mo
Design Phase Alone
Programming Through CDs
Why This Matters for Your Budget: A longer total timeline means a longer period of carrying costs: mortgage or rent on your current home, property taxes on the build site, insurance, and the cost escalation discussed above. It also means a longer period of design and consulting fees accruing before construction even starts. Understanding the full timeline during initial planning prevents the situation where an owner is financially and emotionally prepared for 18 months of construction but not for the 18 months of design and permitting that precede it.

Value Engineering: Aligning Design with Budget

Value engineering is the process of analyzing the design to identify opportunities where equivalent function, performance, or aesthetic quality can be achieved at lower cost, or where the budget can be reallocated from areas of lower impact to areas of higher impact. It is one of the most important deliverables of a well-run pre-construction process, and it is frequently misunderstood.

Value engineering is not cost-cutting. Cost-cutting removes scope or substitutes cheaper materials. It reduces what you get. Value engineering maintains what you get while finding a more efficient way to deliver it. The distinction matters because the goal of value engineering is to protect the design intent and the owner's priorities while bringing the budget into alignment, not to compromise the project in order to hit a number.

Where Value Engineering Creates the Most Impact

The highest-impact value engineering happens early in the design process, during schematic design and design development, before decisions are locked into construction documents. At this stage, changes are inexpensive because they are changes on paper. Once construction documents are complete and permitting is underway, changes require redesign, re-engineering, and potentially re-permitting, all of which carry cost and schedule impact. This is one of the core arguments for engaging a construction manager during design rather than after documents are complete.

Value engineering opportunities exist across every scope category. Structural systems are a common area: a structural engineer may design a system that meets code with significant margin, and a constructability review by an experienced builder can identify areas where the same performance can be achieved with less material or simpler connections, reducing both material cost and fabrication time. Glazing systems offer another opportunity: architects often specify premium window and door systems throughout the house, but a targeted approach that uses the highest-performance systems where they have the most visual impact and standard systems in secondary areas can save hundreds of thousands of dollars without changing the experience of the home. MEP systems, exterior cladding, roofing assemblies, and site development all offer similar opportunities when analyzed by someone who understands both the design intent and the construction cost implications.

How Value Engineering Works on a CMAR Project

On a CMAR project, value engineering is a structured part of the pre-construction process. The construction manager reviews the design at each phase, develops preliminary pricing, identifies the cost drivers, and presents options to the owner and architect for achieving the program within the budget. These options are discussed collaboratively, with the architect providing design perspective, the construction manager providing cost and constructability perspective, and the owner making informed decisions about where to invest and where to optimize. This collaborative dynamic is one of the core reasons owners choose the CMAR model over traditional delivery methods.

This collaborative approach is fundamentally different from what happens on a traditional design-bid-build project, where the owner and architect complete the design, send it out for bids, and discover the cost only after the documents are finished. If the bids come back over budget in that scenario, the options are limited to cutting scope or redesigning, both of which carry cost and delay. Value engineering during design prevents that situation by keeping the budget aligned with the design throughout the process, not just at the end.

Value Engineering vs. Reprogramming

There is an important distinction between value engineering and reprogramming. Value engineering optimizes individual systems and specifications within an established design. Reprogramming is a more fundamental reconceptualization of the project scope, often involving reductions in building area, elimination of major program elements, or significant redesign of the floor plan and site layout.

Reprogramming is what happens when a project reaches the bidding stage without reliable pricing input earlier in the process. A design is completed, permitted, sent out for bids, and the numbers come back significantly higher than expected. At that point, the adjustments required to bring the project within budget go beyond substituting materials or simplifying structural connections. They require rethinking what the project is. That process carries real cost: redesign fees, re-engineering, potentially a new round of plan check, and months of additional schedule. It is one of the most expensive outcomes in residential construction, and it is almost entirely preventable through early construction management engagement during design. Projects that have a construction manager providing cost feedback during schematic design and design development rarely face a reprogramming scenario, because the budget and the design stay aligned as both develop.

The Right Time for Value Engineering
The best value engineering happens before construction documents are complete, when design changes are changes on paper rather than changes to permitted drawings, fabricated materials, or work in place. Early engagement of a construction manager during design is the most effective way to ensure the project is designed to the budget, not budgeted after the design. This is a core benefit of the CMAR delivery method.

From a Range to a Real Number: How Budgets Are Built

The ranges in the next section give you a planning framework. But a planning range and a construction budget are different things. The range tells you what general territory your project falls into, while the budget tells you what it will actually cost to build.

Between those two points, there is an intermediate step that an experienced construction manager can provide early in the process: a Rough Order of Magnitude (ROM) estimate. A ROM is not a budget. It is a structured cost projection developed from the construction manager's direct project experience, calibrated to the specific site, program, and design direction of your project. A well-prepared ROM gives the owner and architect a cost framework during schematic design that is substantially more useful than a generic cost-per-square-foot range, because it accounts for the site-specific conditions, structural requirements, and program elements that drive the actual cost. It is one of the most valuable early deliverables in a CMAR engagement, and it is part of how the budget and the design stay aligned from the beginning.

The Role of Construction Documents

It starts with the drawings. A complete set of construction documents includes architectural plans, structural engineering, civil engineering, MEP engineering, landscape architecture, and specialty consultant drawings. Together, these define every element of the project in sufficient detail for subcontractors to provide firm pricing.

The critical point is that subcontractors price what they see on the drawings. If the drawings are schematic, the pricing will be soft. If the drawings are detailed and coordinated, the pricing will be firm. Drawings that are fully developed, with design decisions resolved, produce an environment where subcontractors can more competitively price the work. The journey from a planning range to a real budget is the journey from conceptual design to biddable construction documents.

Subcontractor Bidding and Market-Validated Pricing

Once the documents are ready for pricing, a well-run pre-construction process solicits competitive bids from pre-qualified subcontractors in each trade. This is where the budget gets grounded in market reality. It is no longer based on rules of thumb, historical averages, or internal cost databases. It is based on what qualified subcontractors are actually willing to do the work for, right now, in the current market.

What a Disciplined Bidding Process Looks Like
A well-run bidding process starts with a pool of experienced subcontractors with proven track records. That means preparing detailed bid forms that define the scope clearly so every bidder is pricing the same work. It means pre-qualifying bidders to ensure they have the capacity, experience, and financial stability to perform. And it means leveling the bids when they come back, because even with clear bid forms, different subcontractors will include or exclude scope items differently, and the apparent low number is not always the actual low number once those differences are reconciled.

The quality of a budget also depends on how transparently the assumptions are documented. Whether there are allowances in the budget (for items not yet fully specified), whether there are contingencies (for unforeseen conditions or design changes), and whether there are pricing assumptions driven by incomplete information or unresolved design details. These are all questions a transparent pre-construction process answers explicitly. On a CMAR project, the owner sees all of this. Every bid, every allowance, every contingency is visible and discussed.

The Path from Range to Budget
Conceptual Design Planning-Level Range Design Development Construction Documents Subcontractor Bidding Bid Leveling Budget Assembly Guaranteed Maximum Price

The practical takeaway: a cost-per-square-foot number provided before you have a complete set of construction documents and competitive subcontractor pricing is an estimate, not a budget. It might be an informed estimate from an experienced builder, and it can be useful for planning. The more developed the documents and the more competitive the bidding process, the more reliable the number becomes. That progression from estimate to budget is what pre-construction is designed to accomplish.

Why a Budget Requires Pre-Construction

The ranges above are useful for early planning. They can help you assess whether a project is feasible at a conceptual level and communicate with your architect about the cost implications of design direction. But turning a range into a buildable budget requires a defined process.

That process is pre-construction. It is the work of analyzing the construction documents, identifying every trade and scope item, soliciting and leveling competitive subcontractor bids, establishing allowances for items not yet specified, building a realistic schedule, and assembling those components into a complete budget with the general conditions, insurance, and fee structure that turns trade costs into a total project cost. That process produces specific deliverables: a trade-by-trade budget with competitive subcontractor bids, a construction schedule tied to the budget, and a scope matrix showing exactly what is included and excluded. Our deliverables page shows what these outputs look like in practice.

On a CMAR project, this process produces a Guaranteed Maximum Price, which is a contractual commitment to deliver the project at or below the budgeted amount. A GMP is provided on a specific, defined scope of work. If the project scope changes through design modifications or owner-directed additions, those changes are addressed through change orders. The value of a well-developed GMP is that it gives the owner cost certainty for the defined scope, built on competitive bids and thorough analysis rather than estimates.

What Is (and Is Not) in the Number

When you receive a construction cost, whether it is a planning-level range or a formal budget, one of the most important questions to ask is what is included. Two numbers at the same price point can represent very different scopes of work depending on what each builder includes in their base number versus what is excluded or carried as an allowance. Understanding the typical inclusions and exclusions helps you compare proposals accurately and plan your total project investment.

Typically Included in the Construction Contract

A comprehensive construction contract on a custom residential project typically includes all site development and civil work shown on the construction documents, the complete building structure from foundation through roof, the full MEP rough-in and trim-out including plumbing fixtures and electrical devices, interior finishes including drywall, paint, flooring, tile, countertops, and cabinetry as specified on the drawings, and general conditions, insurance, and the contractor's fee. Exterior improvements shown on the landscape and civil drawings, including hardscape, irrigation, and landscape planting, are also typically part of the construction scope.

Commonly Excluded or Owner-Furnished

There are several cost categories that typically sit outside the construction contract, even on a comprehensive scope of work. Understanding these exclusions is important because they represent real costs that the owner will need to budget for separately. They are the gap between the construction number and what it actually takes to move into a finished home.

Category Typical Cost Range Who Provides
Appliances (kitchen, laundry) $30K-$150K+ Owner or interior designer; contractor installs
Decorative lighting fixtures $50K-$300K+ Interior designer or owner selects; contractor installs
Window treatments (drapes, shades, hardware) $50K-$200K+ Interior designer; separate installer or contractor
Furniture, art, accessories $200K-$1M+ Owner or interior designer; outside construction contract
Audio/visual equipment (speakers, screens, media) $50K-$250K+ AV integrator; contractor provides infrastructure only
Soft costs (design, engineering, permits, inspections) 15-25% of construction Owner contracts directly with consultants
Builder's risk insurance Varies Owner's insurance broker
Landscape maintenance (post-install) Ongoing Owner contracts separately
The Gap Between the Construction Number and Moving In
On a high-end custom home, the items listed above can collectively add $500,000 to $2M or more on top of the construction contract. When you add soft costs and these commonly excluded items together, the total project cost from design fees through a furnished, move-in-ready home can be 40-60% higher than the construction cost alone. This is not a criticism of how construction contracts are structured. These items are legitimately outside the builder's scope. But owners who budget only around the construction number consistently underestimate the total investment required.

Cost Per Square Foot: A Realistic Framework

With all of the preceding context in place, the cost-per-square-foot ranges at the top of this page should now read differently than they did before you understood the structure behind them. Each range reflects the combined effect of every category discussed above: site conditions, foundation complexity, structural systems, finish level, schedule duration, and the overhead and soft cost layers that sit on top of direct construction cost. Where a specific project falls within its range depends on the interaction of all of these variables, which is why a single number per square foot, without the context this page provides, is not a reliable planning tool. For owners considering a teardown versus renovation, these ranges also frame the cost comparison that drives that decision.

A Note on Small Buildings

Why Small Structures Cost More Per Square Foot
An 800 SF ADU or guest house will almost always have a higher cost per square foot than the main residence on the same property. Many construction costs, including mobilization, site overhead, utility connections, MEP systems, and kitchen and bathroom fit-out, have minimum thresholds that do not scale linearly with building area. When those fixed costs are spread across a small footprint, the per-square-foot cost increases significantly.

For information on how BCG approaches ground-up custom home construction in Los Angeles, including pre-construction budgeting, competitive trade procurement, and the progression from planning ranges to a Guaranteed Maximum Price, see our Ground-Up Custom Homes page.

Frequently Asked Questions

How much does it cost to build a house in Los Angeles?
The cost to build a custom home in Los Angeles varies widely based on site conditions, structural requirements, and finish level. Flat-lot custom homes with quality finishes typically start around $750 per square foot, while hillside projects with complex foundations and high-end finishes range from $1,000 to $1,800 per square foot or more. Numbers below $750/SF generally reflect commodity-level construction with standard off-the-shelf products rather than custom residential work. The most reliable way to develop a budget for a specific project is through pre-construction services with competitive subcontractor pricing.
What is the cost per square foot for new construction in LA?
Cost per square foot depends on site complexity, structural systems, and finish selections. Planning-level ranges for custom residential work run from approximately $750/SF on a flat lot with custom finishes to $1,800/SF or more for complex hillside projects with premium specifications. These ranges reflect current market conditions as of early 2026 and assume a complete scope of work including site development, structure, MEP, and finishes.
Why is hillside construction more expensive?
Hillside construction costs more because of additional site development (grading, retaining walls, shoring, soil export), complex foundation systems (caissons, grade beams), access logistics, erosion control requirements, and extended construction schedules. Site development alone can represent 25-30% or more of total project cost on a hillside property, compared to 10-15% on a flat lot.
How much does a fire rebuild cost in the Palisades?
Fire rebuild costs in PGRAZ zones depend on the scope of reconstruction, current code requirements (which may differ significantly from the original construction), and regulatory requirements specific to the fire zone. The post-fire demand surge has put upward pressure on pricing across the LA market. A rebuild to current code with custom finishes is likely to cost more per square foot than the original construction.
What are general conditions in a construction budget?
General conditions are the project-specific costs of managing and supporting construction: superintendent and project management, temporary facilities, site safety, equipment, clean-up, and administration. On complex residential projects, general conditions typically run 8-15% of hard costs depending on project duration, site complexity, and access conditions. This is not profit. It is the cost of professional site management.
What are soft costs in residential construction?
Soft costs are the design, engineering, consulting, permitting, and regulatory costs that sit outside the construction contract but are part of the total project investment. They include architecture fees, engineering consultants, special inspections and testing, permit and plan check fees, utility connection fees, and expediting services. On custom residential projects in Los Angeles, soft costs typically add 15-25% on top of the construction budget. An owner budgeting $5M for construction should plan for $6M to $6.5M or more in total project cost.
How much contingency should I carry in my construction budget?
A well-structured budget includes three types of contingency. Design contingency (5-10% during design development, reducing as documents are completed) covers scope not yet fully detailed. Construction contingency (5-10% for new construction, 10-15% for renovation) covers unforeseen conditions discovered during the build. Owner contingency (5-10%, held separately) covers owner-directed changes and upgrades. Contingency is not padding. It is professional risk management for a process that involves inherent uncertainty.
How long does it take to build a custom home in Los Angeles?
Construction duration depends on project complexity and site conditions. A flat-lot custom home typically takes 10-14 months of construction. Complex hillside projects run 16-24 months. Large-scale complex projects with extensive site work and amenity programs can take 24-30 months or more. These timelines assume permit in hand at the start of construction; the permitting process adds additional time upstream. The full project timeline from concept through move-in is typically 2.5 to 4 years for a custom home and 3 to 5+ years for a complex high-end project, including design, permitting, and construction. Duration directly affects cost because general conditions are time-based.
How much does a pool cost on a high-end residential project in Los Angeles?
Custom gunite pools on high-end residential projects in Los Angeles typically start at $150,000 and can exceed $500,000 depending on size, site conditions, and features. Vanishing-edge (infinity) pools on hillside sites typically run $400,000 to $750,000 or more due to additional structural engineering, catch basin construction, and site preparation. Integrated spas add $50,000 to $60,000 or more. Pool costs on hillside properties where significant excavation and retaining is required can be substantially higher than flat-lot installations.
How much does it cost to build a basement in Los Angeles?
Subterranean construction in Los Angeles typically costs $800 to $1,200 or more per square foot when accounting for excavation, shoring, structural concrete, waterproofing, and MEP systems. A bare storage or utility space may come in at the lower end of that range, but finished living space with bedrooms, bathrooms, and full systems is typically $1,000/SF or more. A 2,000-square-foot subterranean level with finished living space should be budgeted at $2M to $2.5M or more depending on site conditions and finish level. The cost per square foot for below-grade space is typically 1.5 to 2.5 times the cost of equivalent above-grade space.
What is value engineering?
Value engineering is the process of analyzing a design to find opportunities where the same function, performance, or quality can be achieved at lower cost. It is not cost-cutting. It is about optimizing the budget to protect the design intent and the owner's priorities while bringing the project within budget. The most effective value engineering happens during design, before construction documents are complete, which is one of the core benefits of engaging a construction manager early in the process through the CMAR delivery method.
How much should I budget for interior finishes?
Interior finish costs range from approximately $250-$400/SF for custom-level selections, $450-$600/SF for high-end finishes with custom millwork and imported materials, and $600-$1,000+/SF for top-tier custom interiors. Finish selections are the most variable cost category on any residential project and should be discussed with cost implications in mind early in design.
Why do construction costs vary so much between projects?
Construction costs vary because each project has unique site conditions, geotechnical requirements, structural systems, regulatory constraints, design complexity, and finish specifications. Two identically sized houses on different lots in the same neighborhood can cost millions of dollars apart. This is why generalized cost-per-square-foot numbers have limited value for budgeting a specific project.
Why are construction costs higher in Los Angeles than the national average?
Several factors compound in the LA market that do not apply in most other cities. Seismic design requirements add structural cost to every project. Hillside sites require foundations, shoring, and retaining systems that do not exist on flat terrain. The permitting process in Los Angeles, Beverly Hills, and Malibu is among the most time-intensive in the country, and longer timelines increase soft costs and general conditions. Skilled trade labor rates have increased 25-40% or more since 2019 and have not corrected. Fire zone compliance (VHFHSZ, PGRAZ) adds material and system costs to every project in affected areas. And the post-January 2025 fire demand surge has compressed subcontractor availability across the entire market. None of these factors are optional. They are the cost of building in this geography.
What is a Guaranteed Maximum Price?
A Guaranteed Maximum Price (GMP) is a contractual commitment by the construction manager to deliver the project at or below a specified budget. It is a feature of the Construction Manager at Risk (CMAR) delivery method. A properly developed GMP is built from competitive subcontractor bids, detailed scope analysis, and honest allowances, giving the owner cost certainty that a rule-of-thumb estimate cannot provide.
What is the total cost to build, including everything outside the construction contract?
The total project investment from design fees through a furnished, move-in-ready home is typically 40-60% higher than the construction cost alone. On a $5M construction budget, that means $7M to $8M+ when you include architecture and design fees (8-15% of construction), engineering and consulting, permits and regulatory fees, special inspections, owner-furnished items such as appliances, decorative lighting, window treatments, and furniture, and the various contingencies needed for a well-planned project. Understanding this full investment early in planning prevents budget surprises that compound as the project develops.

If you have a cost question about an existing project or design, or you are planning new construction and want to develop a reliable budget, BCG can help.

Describe Your Situation   |   Tell Us About Your Project

This page provides general information about residential construction costs in Los Angeles and is not intended as financial, contractual, or professional advice. Cost ranges reflect planning-level observations based on the author's experience and current market conditions as of March 2026. Actual project costs depend on site-specific conditions, design complexity, material selections, and market timing. No cost range on this page should be used as a project budget. Reliable budgets require pre-construction services with complete construction documents and competitive subcontractor pricing.
